Re-Engineering a Pole-Mounted Distribution Transformer to IEEE, ANSI, and NESC

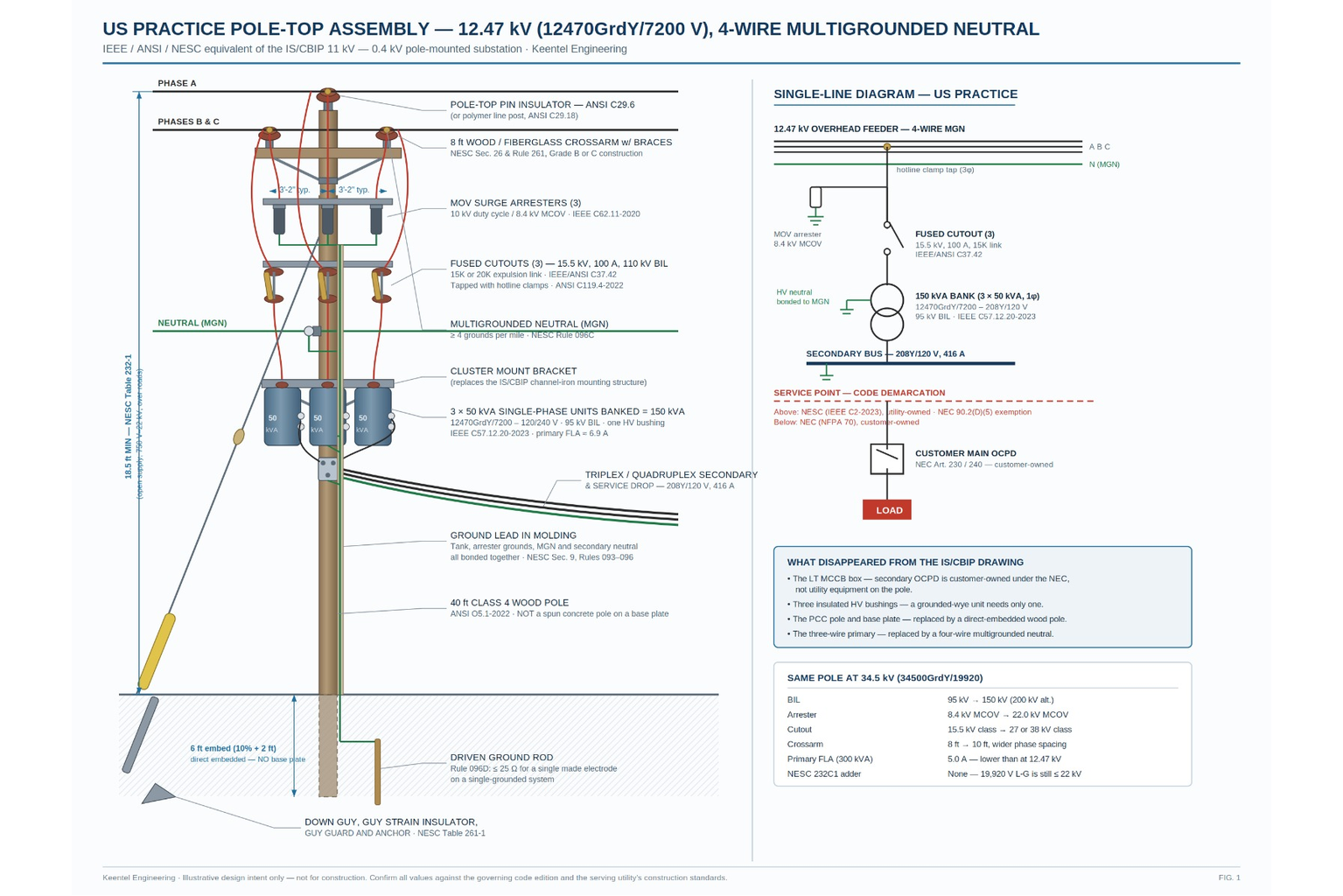

12.47 kV pole-mounted distribution transformer assembly designed for U.S. IEEE and NESC utility standards
A calendar icon featuring a square outline, a top binding, and a grid of dots representing days. D

Aug 20, 2026 | Blog

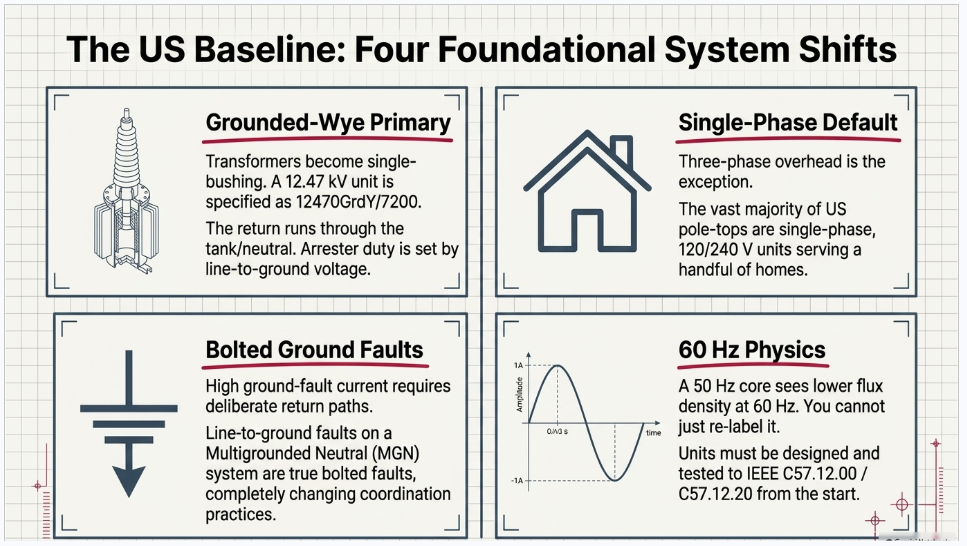

1.  Start with the system

  • Transformers become single-bushing (grounded-wye primary). A 12.47 kV pole-mount unit is typically specified as 12470GrdY/7200 — one primary bushing at 7,200 V line-to-neutral with the return through the tank/neutral. The Indian design’s three fully-insulated primary bushings become one bushing per single-phase unit.
  • Arrester duty is set by line-to-ground voltage, not line-to-line. This is what lets a US 12.47 kV system use a 10 kV duty-cycle arrester where an ungrounded 12 kV system would need substantially more.
  • Single-phase service is the default, not the exception. A large fraction of US pole-top transformers are single-phase, 120/240 V, serving a handful of houses. The three-phase pole-top unit shown in the rendering is the unusual case in US practice, not the base case.
  • Ground-fault current is high and the return path is deliberate. Line-to-ground faults on an MGN system are true bolted faults, sized comparably to three-phase faults, which is why US fusing and coordination practice looks nothing like IEC-region practice.


And frequency matters more than people expect. A 50 Hz core operated at 60 Hz sees lower flux density and different loss and excitation behavior; impedance and regulation shift too. You cannot re-label a 50 Hz transformer as a 60 Hz unit — it has to be designed and tested to IEEE C57.12.00 and C57.12.20 from the start.


2.  Voltage class: what "12 kV" actually means

Per ANSI/NEMA C84.1-2020 (R2025), the standard nominal distribution system voltages are:

Nominal system voltage Line-to-neutral Class Standard BIL (dist. xfmr)
4160Y/2400 2,400 V 5 kV 60 kV
12470Y/7200 7,200 V 15 kV 95 kV (110 kV alt.)
13200Y/7620 7,620 V 15 kV 95 kV (110 kV alt.)
13800Y/7970 7,970 V 15 kV 95 kV (110 kV alt.)
24940Y/14400 14,400 V 25 kV 125 kV (150 kV alt.)
34500Y/19920 19,920 V 35 kV 150 kV (200 kV alt.)

Two notes worth internalizing.


First, 12.47 kV, 13.2 kV, and 13.8 kV all share the 15 kV insulation class. Insulation, arresters, cutouts, and cable are ordered by class, not by nominal voltage. This is why "15 kV class" is the phrase that appears on most US distribution material specs.

Second, C84.1 Range A above 600 V is +5% / −2.5%, not the symmetric ±5% that applies at 600 V and below. On a 12,470 V nominal system, Range A service voltage is 12,157–13,094 V. Designers who carry the ±5% low-voltage habit upward into MV voltage-drop studies will size regulation wrong on the low side.


3.  Component-by-component translation

Rendering (IS/CBIP) US equivalent Governing standard
LA (lightning arrester) MOV surge arrester, distribution class IEEE C62.11-2020
Hot line clamp Hotline clamp / compression connector ANSI C119.4-2022
Disc insulator Porcelain pin, polymer line post, or polymer deadend ANSI C29.2 / C29.5 / C29.6 / C29.7 / C29.13 / C29.18
Cross arm V-bracket 8–10 ft wood or fiberglass crossarm with braces NESC Sec. 26, Rule 261; RUS 1724E-150
D.O. fuse cutout Fused cutout with expulsion fuse link IEEE/ANSI C37.42
Guy assembly Down guy, anchor, guy strain insulator, guy guard NESC Rule 261, Table 261-1
25 kVA, 11/0.4 kV 3-ph 1-ph units banked, or 3-ph pole-mount ≤500 kVA IEEE C57.12.20-2023
LT cable Triplex/quadruplex secondary and service drop NESC Sec. 23; ICEA/NEMA
LT MCCB box Generally not present — see §6
PCC pole, 8 m, base plate Direct-embedded wood pole, 40–50 ft, Class 1–5 ANSI O5.1-2022
Earthing Pole ground bonded to the multigrounded neutral NESC Sec. 9, Rules 093–096

Insulators


The rendering shows disc (suspension) insulators on the primary. In US distribution tangent construction, the phase conductor typically sits on a pin insulator (ANSI C29.5 for low/medium voltage, C29.6 for high-voltage pin) or, increasingly, a polymer line post (C29.18 for distribution line post — note that C29.17 is the transmission line post and is a common miscitation). Suspension/deadend discs per C29.2 appear at deadends, corners, and dead-end riser poles, not at a typical tangent transformer pole.


Poles


This is the most visually obvious change. The US default is a direct-embedded wood pole to ANSI O5.1-2022, not a spun prestressed concrete pole on a base plate. Setting depth follows the standard 10%-plus-2-feet rule of thumb, checked against NESC Section 26 / Rule 261 strength requirements for Grade B or Grade C construction and the applicable Heavy/Medium/Light loading district under NESC Section 25. RUS Bulletin 1724E-150 — the federal design guide for rural distribution — is written almost entirely around unguyed wood poles, Classes 1–6, 35–55 ft.

Spun concrete poles do exist in the US and are covered by ASTM C1089-19 (R2025). They are a deliberate, cost-justified exception (coastal corrosion, fire-hardening, decay zones), not the baseline. And be careful with citations: the ANSI C136 series is roadway and area lighting equipment, not utility distribution concrete poles.


Connectors


The hotline clamp translates directly, but the qualification basis changes. ANSI C119.4-2022 governs aluminum-to-aluminum and aluminum-to-copper connectors on distribution and transmission lines. Its Class A / Class B designations are electrical current-cycle test classes — Class A is 500 current cycles, Class B is 250 — plus separate mechanical strength classes 1, 2, and 3. They are not connector "types," and specifying "Class A" without also specifying the mechanical class leaves the spec incomplete.


Figure 1, on the following page, shows the whole assembly rebuilt — elevation and single-line — alongside a summary of what the 34.5 kV version changes.

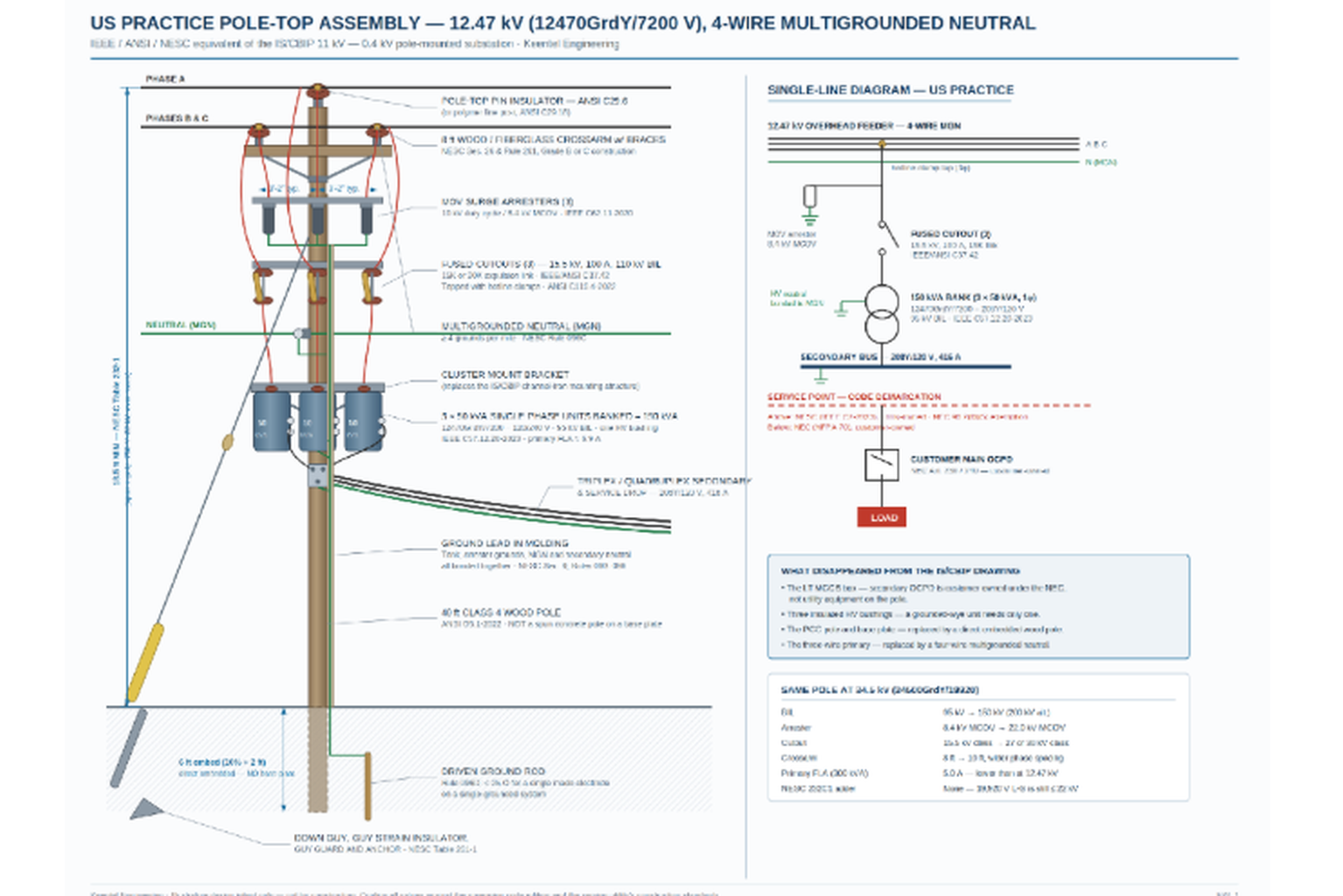

FIGURE 1  —  US-practice pole-top assembly at 12.47 kV (12470GrdY/7200 V), 4-wire multigrounded neutral

The IEEE / ANSI / NESC equivalent of the IS/CBIP 12 kV — 0.4 kV pole-mounted substation. Illustrative design intent only — not for construction.


4.  Worked example A — 12.47 kV suburban commercial tap

Design intent: three-phase, 208Y/120 V service to a small commercial building off a 12.47 kV MGN feeder.

Parameter Value Basis
System 12470GrdY/7200 V, 4-wire MGN ANSI C84.1-2020
Transformer 150 kVA, 3 × 50 kVA 1-ph banked, 7200 – 120/240 IEEE C57.12.20-2023
Secondary connection 208Y/120 V
Primary BIL 95 kV IEEE C57.12.00
Primary FLA 150 kVA ÷ (√3 × 12.47 kV) ≈ 6.9 A
Fuse link 15K or 20K, per utility table IEEE/ANSI C37.42
Cutout 15.5 kV, 100 A cont., 110 kV BIL IEEE/ANSI C37.42
Arrester 10 kV duty cycle / 8.4 kV MCOV (9 kV / 7.65 kV MCOV also valid) IEEE C62.11-2020
Secondary FLA 150 kVA ÷ (√3 × 208 V) ≈ 416 A
Pole 40 ft Class 4 wood, ~6 ft embedment ANSI O5.1-2022
Mounting Cluster mount (1-ph units) or single-pole bracket Utility standard

Three single-phase units banked is deliberate. It is the common US route to three-phase overhead service: stock is standardized, a single failed unit is a cheap replacement, and the bank tolerates open-delta operation if one unit is lost. Three-phase pole-mounted units exist — triplex designs generally 30–225 kVA, T-connected up to 500 kVA — but they are a purchased exception at most utilities, not the default.


5.  Worked example B — 34.5 kV rural / collector tap

Design intent: three-phase, 480Y/277 V auxiliary service off a 34.5 kV line — a very common arrangement for site power at a solar, wind, or BESS facility, and for rural three-phase irrigation and pumping loads.

Parameter Value Basis
System 34500GrdY/19920 V, 4-wire MGN ANSI C84.1-2020
Transformer 300 kVA, 3-ph pole-mount or banked 1-ph, 19920 – 480Y/277 IEEE C57.12.20-2023
Primary BIL 150 kV standard (200 kV alternative) IEEE C57.12.00
Primary FLA 300 kVA ÷ (√3 × 34.5 kV) ≈ 5.0 A
Fuse link 10K–15K, per utility table IEEE/ANSI C37.42
Cutout 27 kV or 38 kV class, 100 A cont. IEEE/ANSI C37.42
Arrester 27 kV duty cycle / 22.0 kV MCOV (30 kV / 24.4 kV MCOV also valid) IEEE C62.11-2020
Secondary FLA 300 kVA ÷ (√3 × 480 V) ≈ 361 A
Pole 45–50 ft Class 2–3 wood; 10 ft crossarm ANSI O5.1-2022

Note what changes and what does not. Primary current falls — 5.0 A at 34.5 kV versus 6.9 A at 12.47 kV for a comparable load — which is exactly why 34.5 kV distribution wins on long rural feeders. What rises sharply is everything driven by dielectric stress: BIL goes 95 → 150 kV, phase spacing widens, crossarms lengthen, and the arrester’s MCOV nearly triples.


One clearance subtlety worth flagging. NESC Rule 232 / Table 232-1 brackets open supply conductors at "over 750 V to 22 kV," and for effectively grounded systems that threshold is applied phase-to-ground. A 34.5Y/19.92 kV system sits at 19,920 V line-to-ground — still inside the 22 kV bracket. So the base vertical clearances apply, and the Rule 232C1 adder of 0.4 in (10 mm) per kV above 22 kV does not kick in. Engineers who apply the adder off the 34.5 kV line-to-line number will over-build every crossing on the line. (Verify against the codebook for your specific configuration; ungrounded and delta systems are treated differently.)


6.  Where the rendering has no US equivalent: the LT MCCB box

This is the most instructive difference on the whole pole.

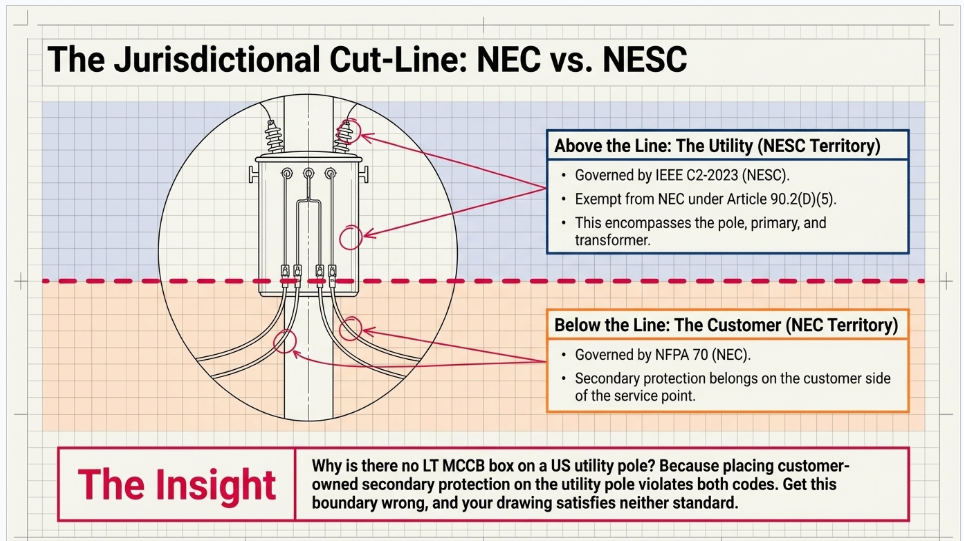

The rendering shows an LT MCCB box below the transformer, and the accompanying SLD runs: overhead feeder → DO fuse cutout → transformer → LT box bus → MCCB → load. That secondary molded-case breaker is standard practice in IS/CBIP distribution substation design.

On a US utility pole, it usually isn’t there. Secondary protection lives on the customer side of the service point, in customer-owned equipment governed by the NEC (NFPA 70). The utility side stops at secondary spades, triplex, and a service drop.


That demarcation is not stylistic — it is jurisdictional. NEC 90.2(D)(5) in the 2023 NEC (90.2(B)(5) in the 2020 and earlier editions) exempts installations under the exclusive control of an electric utility, on utility-owned or leased property, for the purpose of generation, transformation, transmission, or distribution. Everything on that pole is NESC (IEEE C2-2023) territory. Everything past the service point is NEC territory, and NEC Article 450 governs the customer’s transformers, not the utility’s.

Get this boundary wrong and you produce a drawing that satisfies neither code.


7.  Protection philosophy: the part that doesn’t translate at all

The rendering’s SLD implies a straightforward radial cascade. US distribution protection is more layered, and the fuse is designed around it.


Fuse links


Expulsion links per IEEE/ANSI C37.42 come in speed characteristics defined by speed ratio — the ratio of the current that melts the link in 0.1 s to the current that melts it in 300 s (600 s for links above 100 A). Type K links are fast (speed ratio 6–8, nominally 7); Type T links are slow (10–13, nominally 12). Selecting K where a utility standardizes on T, or vice versa, breaks coordination with the upstream device.


Sizing


There is no clean percentage rule, and consultants who quote one are usually quoting a rule of thumb as if it were a standard. Real practice:


  • PG&E’s overhead standard states plainly that transformers are fused at approximately 2.5× nominal rating.
  • Classic guidance holds that minimum blowing current should exceed roughly 200% of transformer FLA, since primary fuses cannot meaningfully protect against overload — the curves don’t match — and exist for fault clearing.
  • S&C Data Bulletin 350-110, the industry selection reference, deliberately uses per-kVA lookup tables, not a multiplier, evaluating continuous peak load at 40 °C ambient, hot-load pickup up to 6× pre-interruption current, and cold-load pickup of 6× for 1 s, 3× for 10 s, and 2× for 15 minutes.
  • Major utilities (JEA among them) publish direct kVA→link tables by system voltage with no percentage rule at all.


The right framing: cold-load and hot-load pickup set the floor, not full-load amps. A transformer that has been de-energized for an hour on a summer afternoon will draw multiples of FLA on restoration, and a fuse sized off FLA will nuisance-blow every time the feeder recloses.


Coordination


The pole fuse must coordinate with the upstream feeder recloser or substation relay, and the utility’s fuse-saving versus fuse-blowing philosophy determines whether the recloser’s fast curve is enabled. That decision is made at the feeder level, not the pole level — which is precisely why a pole-top detail cannot be designed in isolation from the distribution study.


Arresters


Under IEEE C62.11-2020, distribution arresters are still specified as Normal Duty or Heavy Duty (with Heavy Duty Riser as an HD variant). What changed in the 2020 harmonization with IEC 60099-4 was the retirement of line-discharge-class ratings in favor of charge and energy withstand: Qrs (repetitive single-impulse charge transfer), Qth (thermal charge transfer, for distribution arresters), and Wth (switching-impulse energy). Specifications written against the older line-discharge-class language should be updated.


8.  Grounding

The rendering’s "earthing" conductor and base plate become something structurally different in the US: the pole ground is not a standalone earth electrode serving one transformer, it is one of many bonds to a continuous multigrounded neutral.


Governing rules live in NESC Section 9:


  • Rule 096A — resistance to ground low enough to permit prompt operation of protective devices.
  • Rule 096C — multigrounded neutral systems require a minimum of four grounds per mile.
  • Rule 096D — an individual made electrode on a single-grounded system shall not exceed 25 Ω.

A note on standards misuse we see regularly in submitted packages:

IEEE Std 80-2013 is a substation grounding guide — GPR, step and touch potential inside the fenced yard — and IEEE Std 142 (Green Book) covers industrial and commercial premises grounding. Neither is the governing document for a utility distribution pole ground. Citing IEEE 80 for a pole ground is a tell that the design was assembled from references rather than from practice.


9.  If the pole serves a DER site

Increasingly, these assemblies exist to serve or interconnect distributed generation. Once generation is on the customer side of that transformer, IEEE Std 1547-2018 (with amendment 1547a-2020, which widened Category III trip-clearing settings in Table 13) governs interconnection performance, ride-through, protection, and testing. That drives anti-islanding coordination, transformer winding configuration selection, and whether a direct transfer trip or a dedicated interconnection recloser is required — none of which is visible anywhere on the original rendering, and all of which changes the pole.


Standards referenc

Standard Scope
ANSI/NEMA C84.1-2020 (R2025) System and utilization voltage ratings, 60 Hz
IEEE C57.12.00 General requirements, liquid-immersed transformers; BIL and preferred kVA tables
IEEE C57.12.20-2023 Overhead-type distribution transformers, 500 kVA and smaller, ≤34.5 kV
Overhead-type distribution transformers, 500 kVA and smaller, ≤34.5 kV Metal-oxide surge arresters for AC circuits >1 kV
IEEE/ANSI C37.42 High-voltage fuses, cutouts, and accessories
NESC — IEEE C2-2023 Overhead line safety, clearances, strength, grounding
ANSI C119.4-2022 Aluminum/copper distribution and transmission connectors
ANSI C29 series Porcelain, glass, and composite insulators
ANSI O5.1-2022 Wood poles — specifications and dimensions
ASTM C1089-19 (R2025) Spun cast prestressed concrete poles
RUS Bulletin 1724E-150 Design guide for rural electric distribution lines
IEEE Std 1547-2018 / 1547a-2020 DER interconnection and interoperability
NEC (NFPA 70) 90.2 Utility exemption; NEC/NESC jurisdictional boundary

losing


The original rendering is a good teaching drawing. It is also a reminder that a distribution assembly is not a parts list — it is the physical expression of a system philosophy. Change the neutral from three-wire to multigrounded, the frequency from 50 to 60 Hz, the governing code from IS/CBIP to NESC, and the protection basis from a secondary MCCB to a coordinated feeder recloser, and you have not adapted a design. You have replaced it.

At Keentel Engineering, distribution-class assets like these show up constantly at the edges of the work we do — auxiliary and station service at collector substations, gen-tie taps, POI interconnection packages, and utility service to solar, wind, and BESS sites. The interfaces between the utility distribution system and the project are where interconnection schedules slip, and they slip for exactly the reasons above: a clearance applied off the wrong voltage basis, a fuse sized off FLA instead of cold-load pickup, an NEC citation where a NESC rule belonged.

If you have a pole-top, service, or POI detail that needs to be right the first time, we would be glad to look at it.


KEENTEL ENGINEERING


Tampa, FL  ·  Austin, TX  ·  Sacramento, CA  ·  Baltimore, MD

keentelengineering.com   ·   contact@keentelengineering.com   ·   813-389-7871

Engineering note: standards editions, rule numbers, and clearance values cited here were verified against current published sources at time of writing. Always confirm against the governing edition adopted in your jurisdiction and the serving utility’s own construction standards, which frequently exceed code minimums.



A smiling man with glasses and a beard wearing a blue blazer stands in front of server racks in a data center.

About the Author:

Sonny Patel P.E. EC

IEEE Senior Member

In 1995, Sandip (Sonny) R. Patel earned his Electrical Engineering degree from the University of Illinois, specializing in Electrical Engineering . But degrees don’t build legacies—action does. For three decades, he’s been shaping the future of engineering, not just as a licensed Professional Engineer across multiple states (Florida, California, New York, West Virginia, and Minnesota), but as a doer. A builder. A leader. Not just an engineer. A Licensed Electrical Contractor in Florida with an Unlimited EC license. Not just an executive. The founder and CEO of KEENTEL LLC—where expertise meets execution. Three decades. Multiple states. Endless impact.

Four workers in safety vests and helmets stand with arms crossed near wind turbines.

Let's Discuss Your Project

Let's book a call to discuss your electrical engineering project that we can help you with.

Man in a blazer and open shirt, looking at the camera, against a blurred background.

About the Author:

Sonny Patel P.E. EC

IEEE Senior Member

In 1995, Sandip (Sonny) R. Patel earned his Electrical Engineering degree from the University of Illinois, specializing in Electrical Engineering . But degrees don’t build legacies—action does. For three decades, he’s been shaping the future of engineering, not just as a licensed Professional Engineer across multiple states (Florida, California, New York, West Virginia, and Minnesota), but as a doer. A builder. A leader. Not just an engineer. A Licensed Electrical Contractor in Florida with an Unlimited EC license. Not just an executive. The founder and CEO of KEENTEL LLC—where expertise meets execution. Three decades. Multiple states. Endless impact.

Leave a Comment

Related Posts

PRC-023-6 BESS relay loadability compliance guide
By SANDIP R PATEL August 19, 2026
Understand PRC-023-6 for utility-scale BESS: applicability, the 39-month rule, relay loadability, setting criteria, Category 2 IBRs, and audit evidence.
PRC-029-1 voltage ride-through envelope for inverter-based resources.
By SANDIP R PATEL August 18, 2026
Learn PRC-029-1 compliance requirements for inverter-based resources, including voltage and frequency ride-through, EMT studies, protection settings, and testing.
Solar plant electrical testing and commissioning for utility-scale PV systems
By SANDIP R PATEL August 17, 2026
A technical guide to solar plant electrical testing, commissioning, I-V curves, thermography, insulation testing, cable tests and performance acceptance.
Alt Text: Gas-insulated substation engineering guide covering GIS safety, reliability, VFTO, partial
By SANDIP R PATEL August 16, 2026
Explore GIS substation engineering, including design, SF6 safety, VFTO, grounding, commissioning, testing, GIS vs AIS, and IEEE/IEC standards.
Cable testing before energization engineering guide
By SANDIP R PATEL August 16, 2026
Learn the correct cable testing sequence before energization, including VLF, AC/DC withstand, sheath testing, partial discharge, tan delta, and standards.
substation drawing sets
By SANDIP R PATEL August 16, 2026
Explore how substation drawing sets are developed, reviewed and controlled through engineering studies, design milestones, QA/QC and final construction release.
Grid-forming vs grid-following BESS inverters
By SANDIP R PATEL August 15, 2026
Compare grid-forming vs grid-following BESS inverters, control loops, weak-grid stability, protection, compliance, and interconnection study impacts.
MOD-025 and MOD-026 post-COD verification testing with PSS E and PSCAD dynamic model validation
By SANDIP R PATEL August 15, 2026
Learn MOD-025 and MOD-026 post-COD requirements for generator capability verification, PSS®E and PSCAD model validation, IBR testing, and NERC compliance.
Substation inspection checklist engineering guide
By SANDIP R PATEL August 15, 2026
Use this substation inspection checklist to verify QA/QC, grounding, protection, commissioning, documentation, and current IEEE/NETA standards.
