A Coordinated Electric System Interconnection Review—the utility’s deep-dive on technical and cost impacts of your project.

Challenge: Frequent false tripping using conventional electromechanical relays
Solution: SEL-487E integration with multi-terminal differential protection and dynamic inrush restraint
Result: 90% reduction in false trips, saving over $250,000 in downtime

Category Metric
VPP capacity (Lunar Energy) 650 MW
Lunar funding raised US$232 million
Data center BESS example 31 MW / 62 MWh
ERCOT grid-scale batteries 15+ GW
LDES tenders (H1 2026) Up to 9.3 GW
Lithium-ion share of LDES by 2030 77%
FEOC initial threshold 55%
BESS tariff rate (2026) ~55%
Capacity gain from analytics 5–15%

NERC Compliance and PRC Alignment with SEL-351S Feeder Protection Applications

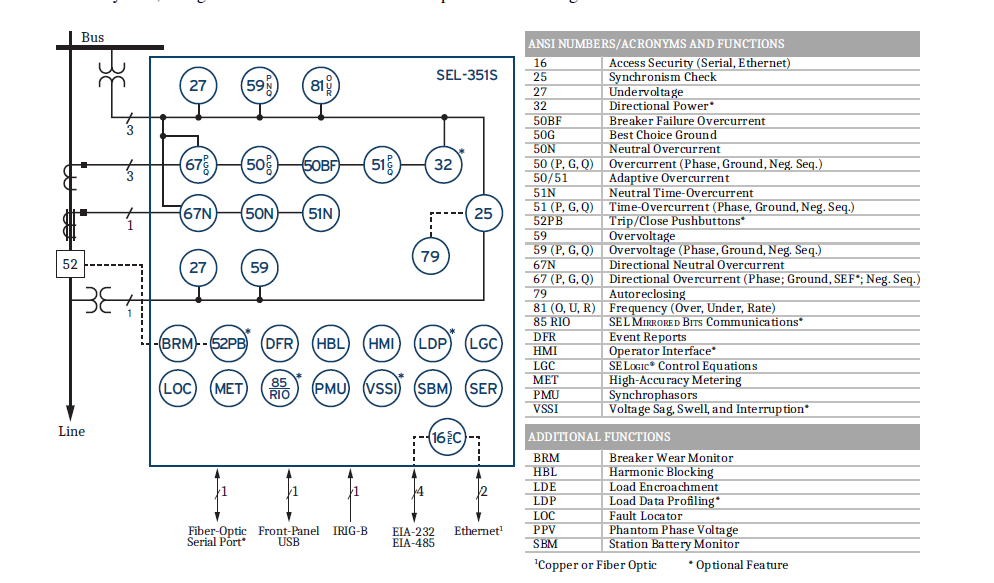

SEL-351S feeder protection relay functional diagram showing ANSI protection elements supporting NERC PRC compliance for substation feeder protection systems.
Calendar icon. D

Feb 20,2026  | blog

Executive Overview

  • Transmission Owners (TO)
  • Generator Owners (GO)
  • Generator Operators (GOP)
  • Distribution Providers (DP)
  • Transmission Operators (TOP)


This section provides a detailed alignment between SEL-351S protection functions and key PRC standards including:


  • PRC-005 – Protection System Maintenance
  • PRC-023 – Transmission Relay Loadability
  • PRC-024 – Generator Frequency and Voltage Protection
  • PRC-026 – Relay Performance During Stable Power Swings
  • PRC-027 – Coordination of Protection Systems
  • PRC-019 – Coordination of Generating Unit or Plant Capabilities
  • PRC-028 – Event Reporting and Misoperation Analysis
  • PRC-029 – Disturbance Monitoring and Model Validation (IBR relevance)


Keentel Engineering provides full lifecycle support including protection design, documentation, settings validation, testing, and audit support aligned with NERC compliance programs.


1. PRC-005 – Protection System Maintenance

Standard Intent

PRC-005 requires entities to establish and implement a documented Protection System Maintenance Program (PSMP) ensuring that protection systems are maintained and tested at defined intervals.


Protection Systems include:


  • Protective relays
  • Associated instrument transformers (CTs/PTs)
  • DC supply
  • Trip coils
  • Communications systems
  • Control circuitry

SEL-351S Compliance Support Features

1. Self-Monitoring and Diagnostics


The SEL-351S continuously performs internal self-tests and reports abnormal conditions via:


  • Relay Word bits
  • Alarm outputs
  • Event reports
  • Front-panel indicators


This supports condition-based maintenance and reduces reliance solely on time-based intervals.


2. Oscillography and Event Recording

The relay provides:

  • 15-, 30-, or 60-cycle oscillography
  • Up to 128 samples per cycle
  • Sequential Events Recorder (SER)


These capabilities support:


  • Verification of protection operation
  • Post-maintenance validation
  • Misoperation investigations


3. Breaker Wear Monitoring

SEL-351S integrates:

  • Interruption current monitoring
  • Close-to-open count tracking
  • Manufacturer wear curve integration
  • Operate time recording


This directly supports PRC-005 requirements for monitoring:


  • Trip circuit performance
  • Breaker health
  • Mechanical operation timing


Keentel Engineering includes breaker wear data in maintenance documentation packages.


4. DC Supply Monitoring

The relay measures and records station battery voltage.


This supports:


  • DC system supervision requirements
  • Documentation of minimum trip voltage during operation
  • Early detection of charger or battery degradation


5. Documentation and Evidence Preparation

For PRC-005 audits, Keentel provides:


  • Maintenance interval matrix
  • Test procedures aligned with relay functionality
  • Event record validation documentation
  • Breaker timing reports
  • Battery voltage trend logs
  • Protection element functional test reports

2. PRC-023 – Transmission Relay Loadability

Standard Intent

PRC-023 requires transmission protective relays to be set so they do not operate unnecessarily for stable power swings or expected load conditions.

SEL-351S Compliance Alignment

1. Load Encroachment Logic


The SEL-351S includes positive-sequence impedance-based load encroachment blocking.

This allows:


  • Overcurrent elements to be set below peak load
  • Secure operation during heavy load
  • Compliance with loadability margins


2. Negative-Sequence Protection Use


Where phase elements must be raised to satisfy PRC-023 loadability, negative-sequence elements provide:


  • Sensitive fault detection
  • Security during balanced heavy load


3. Keentel Engineering Compliance Process


For PRC-023 validation, we provide:


  • Peak loading study
  • Emergency rating analysis
  • Impedance margin verification
  • Load encroachment impedance region documentation
  • Relay setting justification report

3. PRC-024 – Generator Frequency and Voltage Protection

Standard Intent

PRC-024 ensures that generator protective relays do not trip generating units for frequency or voltage excursions within defined ride-through curves.

SEL-351S Compliance Features

The relay includes:


  • Six levels of 81U/81O frequency protection
  • Multiple 27/59 voltage elements
  • Adjustable time delays
  • Undervoltage supervision of frequency elements

1. Ride-Through Curve Coordination


Keentel Engineering performs:


  • Overlay of NERC PRC-024 ride-through curves
  • Frequency element pickup/time verification
  • Voltage element pickup/time verification
  • Confirmation of no overlap within “no-trip zone”


2. Documentation Package


We prepare:



  • Ride-through comparison plots
  • Relay setting sheets
  • Time-domain simulation results
  • Compliance certification letter

4. PRC-026 – Relay Performance During Stable Power Swings

While PRC-026 primarily applies to out-of-step relays, feeder relays can contribute to system performance issues if improperly set.


The SEL-351S supports compliance through:


  • Load encroachment logic
  • Directional supervision
  • Secure negative-sequence logic
  • ROCOF supervision (when applied correctly)


Keentel validates relay stability during:


  • Stable swing simulations
  • Load transfer events
  • Large motor starting scenarios

5. PRC-027 – Coordination of Protection Systems

Standard Intent

PRC-027 requires coordination of protection systems for BES Elements.

SEL-351S Compliance Alignment


The relay supports:


  • IEEE and IEC inverse curves
  • 38 recloser curves
  • Adjustable time-dial ranges
  • Fast/slow coordination logic
  • Directional coordination
  • Sequence coordination logic


Keentel Engineering Deliverables



  • Complete Time-Current Coordination (TCC) study
  • Downstream device coordination analysis
  • Fault current study
  • Curve overlay documentation
  • Settings coordination summary report

6. PRC-019 – Generator Capability Coordination

Where SEL-351S is used at generator interconnection points:


  • Voltage elements must not conflict with AVR capability
  • Frequency elements must not conflict with governor limits
  • Reverse power must align with generator protection philosophy


Keentel validates:


  • Generator capability curve overlays
  • Protective element interaction analysis
  • Voltage/frequency stability margins

7. PRC-028 – Misoperation Analysis and Reporting

SEL-351S provides detailed disturbance evidence including:


  • High-resolution oscillography
  • SER with millisecond time stamping
  • Relay Word bit tracking
  • Synchrophasor data (if enabled)


Keentel Engineering supports:


  • Misoperation root cause analysis
  • Evidence preservation packages
  • Protection redesign recommendations

8. PRC-029 – Disturbance Monitoring and Model Validation (IBR Relevance)

When applied in inverter-based resource (IBR) applications:


  • ROCOF elements must align with interconnection requirements
  • Voltage ride-through must match model assumptions
  • Synchrophasor output may support model validation


Keentel provides:



  • PSCAD / PSSE ride-through simulations
  • Model validation reports
  • Relay logic alignment documentation

9. Audit-Ready Documentation Package

Keentel Engineering provides a complete NERC-ready compliance binder including:


  1. Protection Philosophy Document
  2. Relay Settings Justification Report
  3. Loadability Study (PRC-023)
  4. Ride-Through Study (PRC-024)
  5. Coordination Study (PRC-027)
  6. Maintenance Program Matrix (PRC-005)
  7. Breaker Monitoring Reports
  8. Event Record Archive
  9. Synchrophasor Configuration Documentation
  10. Compliance Attestation Letter

10. Risk Mitigation Through Proper Engineering

Improper configuration of feeder relays can lead to:


  • Nuisance tripping
  • Generator ride-through violations
  • Protection misoperations
  • NERC audit findings
  • Financial penalties


Properly engineered SEL-351S applications, supported by Keentel Engineering, mitigate these risks through:



  • Protection stability analysis
  • Verified load encroachment boundaries
  • Directional element validation
  • Breaker failure timing verification
  • Fault simulation and relay response testing

Conclusion

The SEL-351S is not merely a feeder overcurrent relay it is a comprehensive protection, automation, and monitoring platform capable of supporting full alignment with NERC PRC reliability standards when properly engineered.


Through detailed studies, documentation, and validation processes, Keentel Engineering ensures:


  • Technical protection integrity
  • System reliability
  • Regulatory compliance
  • Audit readiness
