Part 2 — Frequently Asked Questions: Large Load Interconnection

An electric grid must remain in continuous balance — generation onto the grid must equal consumption from it at every instant. PJM achieves this balance, and prices it, through a layered market architecture. Each layer operates on a different time horizon, and each one touches project economics differently.

Inside a Battery Energy Storage System

PJM interconnection rulebook guide by Keentel Engineering
A calendar icon featuring a square outline, a top binding, and a grid of dots representing days. D

Jul 18, 2026 | Blog

1. Introduction: The Grid Was Never Built for This

The power grid was engineered around a simple premise: large, dispatchable, synchronous generators producing steady, predictable power, scheduled by a central operator. Renewable energy breaks every clause of that premise. Solar output collapses at sunset and swings with every passing cloud; wind rises and falls with the weather; both connect through power electronics rather than rotating machines. Yet national policy worldwide is pushing renewable penetration relentlessly higher — with individual country targets measured in the hundreds of gigawatts by 2030 — and there is no going back to a fossil-dominated fleet.


So the defining question of the modern grid is blunt: how do you keep the lights on when the sun sets and the wind stops? A single containerized battery unit of the kind now rolling off production lines can power on the order of a hundred homes simultaneously — and, more importantly, can help stabilize the entire grid around it. That technology is the Battery Energy Storage System, or BESS. It is often dismissed as 'a giant battery box.' It is not. A grid-scale BESS is a highly engineered system of systems — electrochemical, power-electronic, thermal, protective, and digital — and every one of those subsystems has to be designed, integrated, studied, and commissioned correctly for the asset to be safe, bankable, and grid-compliant. This article walks through why BESS exists, what it does for the grid, and — component by component — what is actually inside the box.


2. Four Problems Renewables Create for the Grid

2.1 Fluctuating, Uncontrollable Output


Renewable output is dictated by nature, not by dispatch instructions. A solar plant produces only while the sun shines; output falls to zero at dusk and fluctuates continuously under cloud cover during the day. Wind output varies with wind speed on timescales from seconds to seasons. The legacy grid was designed for steady, schedulable generation, and it has no inherent mechanism for absorbing rapid, frequent, weather-driven power swings while holding frequency and voltage within limits.


2.2 Declining System Inertia


Conventional plants use large synchronous generators whose heavy rotating masses store kinetic energy — inertia. The intuition is a bicycle wheel: once spinning, it keeps rotating even after you stop pedaling. When a generator trips or load steps suddenly, that stored rotational energy resists the frequency change instantly, slowing the rate of change of frequency (RoCoF) and buying time for slower controls to respond. Inverter-based renewables have no rotating parts; every synchronous megawatt they displace removes inertia from the system. As penetration rises, frequency control becomes harder and the risk of fast, deep frequency excursions grows. (For a full treatment of how grid-forming inverters restore synthetic inertia, see our companion publication on grid-forming technology.)


2.3 Loss of Visibility and Controllability


Operators once enjoyed near-total visibility and centralized control: thermal, hydro, and nuclear output could be scheduled and adjusted on command. Renewable generation is inherently uncertain — accurate forecasting of solar and wind, short-term and long-term, remains difficult — and renewable plants are geographically dispersed, frequently connected at weak points in the network. Centralized dispatch gives way to a coordination problem of far higher dimensionality.


2.4 Erosion of Reactive Power Control


Reactive power is sometimes dismissed as 'useless power.' In reality it is the currency of voltage control: shunt reactors, capacitor banks, and generator excitation systems all regulate voltage by managing reactive power. As conventional plants retire and simple grid-following solar inverters proliferate — many historically operated at unity power factor with no reactive contribution — the system's reactive resources thin out precisely as its need for dynamic voltage support grows.

KEENTEL INSIGHT

These Are Interconnection Problems, Not Abstractions

Every one of these four problems shows up concretely in interconnection studies: ramp-rate and curtailment provisions, RoCoF and frequency ride-through requirements, forecasting and telemetry obligations, and reactive capability ranges specified at the point of interconnection. A BESS that is engineered against the grid code from day one clears these hurdles; one specified as a commodity 'battery box' does not.


3. Why Batteries Won the Storage Race

Battery storage is not the only storage technology, and it did not win by default. Pumped hydro stores enormous energy but demands specific geography and offers limited flexibility for fast grid services. Flywheels respond in milliseconds but store energy for only short durations. Thermal storage is application-specific. Hydrogen holds long-duration promise but still faces round-trip efficiency and cost hurdles. Each serves a purpose; none serves every purpose.

Technology Strength Limitation
Pumped hydro Very large energy capacity; proven at scale Geography-dependent; slow to site and permit; limited fast-service flexibility
Flywheel Millisecond response; high cycle life Seconds-to-minutes duration only
Hydrogen Long-duration and seasonal potential Low round-trip efficiency; developing cost base
Battery (BESS) Fast response, siting flexibility, modular scaling, multi-service capability Duration economics; degradation management; fire safety engineering

BESS is the one technology that can plausibly address the full stack of grid needs: it responds in milliseconds, sites almost anywhere, scales modularly — need more capacity, add another enclosure — and serves many applications from one asset: energy shifting and arbitrage, peak shaving, frequency regulation and fast frequency response, renewable output smoothing, reactive power and voltage support, transmission and distribution deferral, resource adequacy capacity, and even black start. Think of it as a power bank for the entire grid — but one that also talks back to the grid in real time.


4. Inside the Box: The Anatomy of a BESS

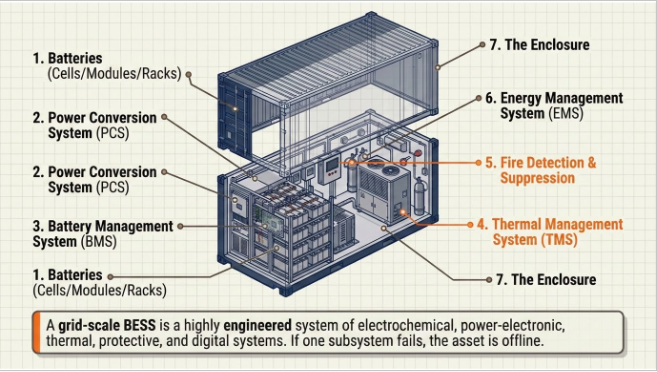

Grid-scale BESS components including batteries, PCS, BMS, EMS, thermal management, and fire protection

A representative modern outdoor cabinet packs on the order of 250 kWh into a single weatherproof enclosure; utility-scale sites parallel hundreds of such units or larger containers into plants of hundreds of megawatt-hours. Whatever the scale, the same subsystems appear, and each deserves engineering attention.


4.1 The Battery: Cells, Modules, and Racks


There is no single giant battery inside. The energy store is built hierarchically: individual electrochemical cells are assembled into modules; modules are connected — typically in series — into racks or packs; racks are paralleled to form the DC block. The hierarchy is deliberate. Modularity localizes both failure and maintenance: a faulty module can be isolated, extracted, and replaced without disturbing the rest of the system.

Today's grid-scale market is dominated by lithium-ion chemistry, and within lithium-ion, lithium iron phosphate (LFP) has become the workhorse for stationary storage. The reasons are practical: competitive cost per kilowatt-hour, high energy density in a compact footprint, long cycle life, and — critically for stationary applications — better thermal stability and a higher thermal-runaway onset threshold than nickel-rich chemistries. Chemistry selection still matters at the project level: cycle-life warranties, calendar aging, temperature sensitivity, and end-of-life augmentation strategy all trace back to the cell.


4.2 Power Conversion System (PCS): The Translator


Batteries speak DC; the grid speaks AC. The Power Conversion System is the bidirectional translator between the two. Charging, it operates as a rectifier — converting grid AC to DC at the battery bus voltage. Discharging, it operates as an inverter — converting the battery's DC back to grid-compatible AC. In a representative cabinet-scale system, the PCS converts a low-voltage AC connection (on the order of 400 V) to a DC bus in the 800+ V range and back again; utility-scale PCS units operate at higher powers with medium-voltage step-up transformers immediately downstream.

PCS packaging follows two patterns: integrated within the same cabinet as the batteries, or housed in dedicated PCS cabinets or containers — the norm on large projects. Either way, the PCS is a single point of consequence: if it fails, the unit can neither charge nor discharge, and the asset is offline. PCS selection also determines far more than power rating — grid-support capability (reactive power range, ride-through behavior, and increasingly grid-forming capability), harmonic performance, efficiency curves, and overload headroom are all set here. On the modern grid, the PCS is where a battery stops being a load/source and becomes a grid asset.


4.3 Battery Management System (BMS): The Watchdog


Hundreds of cells sharing current raises an obvious question: who ensures no individual cell is over-stressed — over-temperature, over-voltage, over-current — while the fleet charges and discharges? Unmanaged, cell-level abuse is the road to thermal runaway. The Battery Management System is the embedded watchdog that prevents it. 'Embedded' is the operative word: unlike a general-purpose computer, a BMS is purpose-built firmware doing one job — the way a washing machine controller runs wash cycles and nothing else. Its four core functions:


  • Monitoring. Continuous measurement of cell and module temperatures, voltages, and currents, published to every other stakeholder in the control chain.
  • Protection. On detecting an out-of-limit condition, the BMS commands the distribution/disconnection hardware to isolate the affected module before a local fault escalates.
  • Performance optimization. The BMS maintains state-of-charge (SOC) and state-of-health estimates and performs cell balancing, so the energy management layer can make accurate charge/discharge decisions and the plant delivers its rated capacity over life.
  • Communication. The BMS is in constant dialogue with the PCS and the plant EMS; every protective action and every dispatch decision depends on the data it streams.

KEENTEL INSIGHT

SOC Accuracy Is a Revenue Issue

SOC estimation quality is commonly treated as a battery-health topic. It is equally a market topic: available-energy misreporting flows straight into dispatch errors, availability penalties, and settlement disputes. Duty cycles with sustained low-magnitude currents — frequency response and inertial services in particular — sit exactly where current sensing is least accurate, so BMS measurement architecture should be evaluated against the intended service stack, not just against nameplate cycling.

4.4 Thermal Management System (TMS): Keeping Chemistry Comfortable


Even the smartest electronics cannot help a battery that is running hot. A useful rule of thumb: if the temperature is uncomfortable for a human, it is probably uncomfortable for a lithium-ion cell. Performance is best in roughly the 20–40 °C band. Run colder and performance and available capacity drop; run hotter and electrolyte heating accelerates degradation and, at the extreme, initiates thermal runaway. Packing hundreds of kilowatt-hours into a compact enclosure guarantees heat, so heat must be actively removed.


Two architectures dominate. HVAC (forced-air) systems suit lower energy densities and some site conditions; liquid cooling — coolant pumped through module-level cold plates from pumps at the base of the enclosure — has become the default for compact, high-density products because it removes heat where it is generated and holds tighter cell-to-cell temperature uniformity. Uniformity matters as much as absolute temperature: thermal gradients across a rack drive uneven aging, which erodes usable capacity years before warranty end.


4.5 Fire Detection and Suppression: Engineering for the Bad Day


A BESS concentrates an enormous amount of stored energy, and the honest engineering position is that a fully developed lithium-ion battery fire is extraordinarily difficult to extinguish. The design objective is therefore early detection and escalation prevention, not heroic firefighting. A modern enclosure carries a layered sensor suite — smoke, off-gas, temperature, and humidity detection — monitoring conditions continuously and feeding the suppression controller. Off-gas detection deserves emphasis: cells vent characteristic gases before thermal runaway fully develops, so gas sensing provides the earliest actionable warning in the sequence.


Suppression architecture scales with the enclosure. At module level, aerosol-based suppression is common in cabinet-class products: a heat-activated tube ruptures and floods the affected module, containing the event within that module. Larger 20-foot containers employ different schemes — clean-agent flooding, water-based systems, dedicated deflagration venting — selected against the specific enclosure volume and energy. In all cases, suppression is one layer of a defense-in-depth stack that includes cell chemistry selection, BMS protective action, thermal management, enclosure-level gas management, spacing and separation, and emergency response planning — the framework codified in NFPA 855 and validated through UL 9540A large-scale fire testing.


4.6 Energy Management System (EMS): The Brain


With storage, conversion, and safety in place, one question remains: when should the plant charge, and when should it discharge? Get it backwards — charging at peak prices and discharging into the trough — and an arbitrage asset loses money on every cycle. The Energy Management System is the software layer that makes those decisions automatically. It sits in constant communication with the BMS (state of charge, available capacity, health) and commands the PCS (charge, discharge, setpoints), executing whatever application logic the owner programs: arbitrage, peak shaving, frequency response stacking, renewable smoothing, or coordinated multi-service dispatch.


It is fair to say the EMS decides whether a BESS is a good investment or merely a functioning one: two identical hardware plants with different EMS strategies produce very different revenue. On utility-scale sites the EMS also integrates upward — into plant SCADA, operator telemetry, and market bidding systems — which makes cybersecurity, protocol compliance, and dispatch-latency performance genuine engineering requirements rather than IT afterthoughts.


4.7 The Enclosure: More Than a Metal Box


Everything above lives inside an enclosure engineered for decades outdoors. Cabinet-class products carry ingress protection ratings on the order of IP55 — sealed against dust and water jets, suitable for harsh environments — with corrosion-rated construction for coastal and industrial atmospheres. The enclosure is also where modular scaling happens: additional capacity means placing and paralleling another cabinet, not redesigning the plant. At utility scale, the same role is played by purpose-built containers with integrated thermal, fire, and access systems.


4.8 Beyond the Box: Balance of Plant



The container is where the product ends and the project begins. A grid-connected BESS still requires: medium-voltage step-up transformers and switchgear; AC collection design; protective relaying coordinated across the PCS, feeders, and point of interconnection; grounding and lightning protection; auxiliary power for cooling and controls (a real and often underestimated load); SCADA and metering; and civil works. Interconnection itself brings power system studies — load flow, short circuit, protection coordination, harmonics, and increasingly EMT-level dynamic studies as grid codes tighten for inverter-based resources. This balance-of-plant and studies scope is where projects most often stall — and where disciplined engineering pays for itself.


5. Sizing, Augmentation, and Life-Cycle Design

Correct sizing is a system exercise, not a datasheet lookup. Power (MW) and energy (MWh) ratings must be derived from the application stack — a frequency-response asset and a four-hour capacity asset are different machines. Usable energy differs from nameplate: depth-of-discharge windows, temperature derating, auxiliary consumption, and conversion losses all subtract. And batteries degrade: a plant sized exactly to its day-one requirement fails its requirement in year three. Life-cycle design therefore builds in either initial oversizing or a planned augmentation program — physical space, DC architecture, and interconnection headroom reserved for adding modules as capacity fades. The modular cabinet architecture makes augmentation practical, but only if the plant was engineered for it from the start.

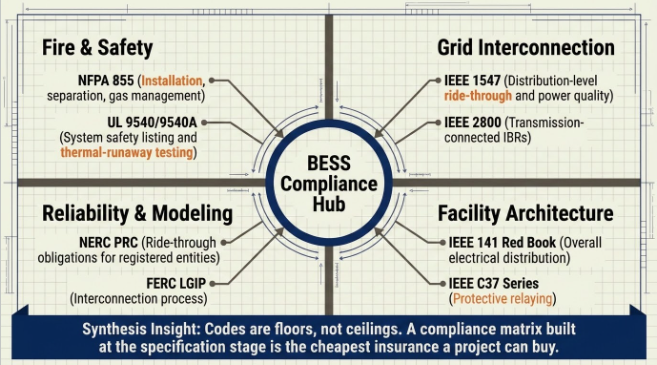

6. Standards and Codes Every BESS Project Must Satisfy

Domain Key Standards / Codes What They Govern
Fire safety NFPA 855; UL 9540 / UL 9540A Installation requirements, separation, gas management; system safety listing and thermal-runaway fire testing
Grid interconnection IEEE 1547 (distribution); IEEE 2800 (transmission IBRs) Ride-through, reactive capability, power quality, and performance at the point of interconnection
Power quality IEEE 519 Harmonic distortion limits at the PCC
Protection & grounding IEEE 80 / 81 / 142; C37 series Grounding system design and testing; protective relaying
Reliability compliance NERC standards (incl. PRC ride-through requirements) Registered-entity obligations for grid-connected storage

Codes are floors, not ceilings. Utility-specific interconnection requirements, insurer expectations, and local AHJ interpretations routinely exceed the published minimums — and they change. A compliance matrix assembled at the specification stage, and maintained through commissioning, is the cheapest insurance a BESS project can buy.


7. How Keentel Engineering Supports BESS Projects

Keentel Engineering LLC provides independent, vendor-neutral engineering across the full BESS life cycle:


  • Concept & Sizing. Feasibility, application-stack definition, MW/MWh sizing, usable-energy and degradation modeling, and augmentation planning.
  • Grid Interconnection & Studies. Interconnection applications and studies — load flow, short circuit, protection coordination, harmonics, and EMT dynamic modeling for IBR grid-code compliance.
  • Technology Procurement Support. Specification and bid evaluation of batteries, PCS, BMS, TMS, fire protection, and EMS; factory and site test witnessing; vendor claim verification.
  • Balance-of-Plant Design. Substation and MV collection design, protective relaying, grounding (IEEE 80/81), auxiliary systems, and SCADA integration.
  • Safety & Code Compliance. NFPA 855 / UL 9540A compliance review, hazard mitigation analysis, and coordination with AHJs and insurers.
  • Owner's Engineer & Compliance. Owner's engineer services from contract through commissioning, plus NERC compliance program development for operating assets.

Case Studies

The following case studies are drawn from representative engagements. All client, project, personnel,

and location identifiers have been removed or generalized to protect confidentiality.


Case Study 1: Utility-Scale Standalone BESS — Interconnection and

Grid-Code Compliance


Challenge


A developer advancing a 100 MW / 400 MWh standalone BESS faced a transmission

interconnection process with tightening inverter-based resource requirements, including EMT model

submission and demonstrated ride-through compliance. The originally proposed equipment package

had been selected on price, and its PCS dynamic models were incomplete against the interconnecting

utility's requirements — putting the queue position at risk of restudy delays.


Approach


Keentel built a requirement-by-requirement compliance matrix from the applicable grid code

and utility technical standards, then benchmarked the vendor's EMT models against it. Gaps were

documented and driven back to the supplier for model correction and, where hardware capability was

the constraint, reflected in a revised PCS specification. Keentel executed the supporting study suite —

load flow, short circuit, protection coordination, harmonic screening against IEEE 519, and EMT dynamic

verification of ride-through and reactive capability at the point of interconnection — and prepared

submission-ready documentation.


Outcome


The project cleared its interconnection study cycle without a restudy loop, the equipment

specification was corrected before purchase orders were placed, and the developer retained its queue

position and financing timeline. The compliance matrix remained in service through commissioning as

the master verification document.


Case Study 2: Industrial Peak Shaving BESS — Sizing, Protection, and

Savings Verification


Challenge


A large industrial facility with sharp demand peaks sought a behind-the-meter BESS to reduce

demand charges. Vendor proposals ranged widely in power and energy ratings, and the facility's aging

medium-voltage distribution raised protection coordination and power quality questions that no bidder

had addressed.


Approach


Keentel analyzed a full year of interval load data to characterize peak frequency, magnitude,

and duration, then sized the system against the facility's actual tariff structure — accounting for usable-

energy deratings, auxiliary consumption, round-trip efficiency, and end-of-warranty degradation rather

than nameplate figures. The engagement included protection coordination across the new PCS and

existing switchgear, harmonic assessment of the converter against facility power quality limits, thermal

and fire-code review of the proposed indoor-adjacent siting per NFPA 855, and a revised siting

recommendation to an outdoor pad with code-compliant separation.


Outcome


The right-sized system came in materially smaller than the leading vendor proposal while

capturing effectively the same demand-charge savings, the protection scheme was coordinated before


Inside a Battery Energy Storage System — All Components Explained


keentelengineering.com | © 2026 Keentel Engineering LLC Page 15 of 1

installation rather than patched after, and first-year measured savings tracked the engineering model

within a few percent — supporting the facility's internal capital case for a second phase.


Case Study 3: Operating BESS Fleet — Safety Compliance and

Augmentation Roadmap


Challenge


An asset owner operating multiple cabinet-based BESS installations commissioned in earlier

code cycles needed a portfolio review: authorities and insurers were signaling alignment with current

NFPA 855 expectations, and measured capacity fade across the fleet was outpacing the original revenue

model.


Approach


Keentel performed site-by-site gap assessments against current fire-safety expectations —

detection coverage (including off-gas sensing), suppression architecture, separation distances, gas

management, signage, and emergency response documentation — and prioritized findings by risk and

cost. In parallel, Keentel analyzed BMS-recorded operating data to model degradation trajectories per

site, then developed an augmentation roadmap: which sites could accept additional cabinets within

existing electrical and spatial headroom, which required interconnection amendments, and the optimal

sequencing of augmentation capital against contracted revenue obligations.


Outcome



The owner received a defensible, prioritized compliance program accepted by its insurer,

avoided a blanket retrofit by targeting only the genuinely deficient sites, and adopted a staged

augmentation plan that restored contracted capacity at the lowest net present cost — converting a

looming portfolio problem into a scheduled maintenance program.


Frequently Asked Questions

  • Q1. What exactly is a BESS?

    A Battery Energy Storage System is an integrated, grid-connected system — not just a battery —

    comprising electrochemical storage (cells, modules, racks), a bidirectional power conversion system

    (PCS), a battery management system (BMS), thermal management, fire detection and suppression, an

    energy management system (EMS), and a weatherproof enclosure, all supported by balance-of-plant

    equipment. It stores surplus electrical energy and dispatches it back to the grid on command, while also

    providing real-time grid services.

  • Q2. Why does the grid suddenly need storage?

    Because renewables broke four assumptions the grid was built on: output is now fluctuating and

    weather-driven rather than schedulable; system inertia falls as synchronous machines are displaced by

    inverters; operator visibility and centralized control diminish as generation disperses; and reactive

    power resources for voltage control thin out. Storage is the one technology that addresses all four while

    remaining fast, siteable, and modular.

  • Q3. What is inertia, in plain terms?

    The kinetic energy stored in the heavy rotating shafts of conventional generators — like a bicycle wheel

    that keeps spinning after you stop pedaling. When a disturbance hits, that stored energy resists the

    frequency change instantly, slowing the rate of change of frequency and buying time for controls to act.

    Inverter-based renewables carry none, which is why declining inertia is a defining challenge of high-

    renewables grids — and why grid-forming BESS, which emulates inertia in software, is increasingly

    required by grid codes.

  • Q4. Why did lithium-ion — and LFP specifically — come to dominate grid storage?

    Cost-effectiveness and packaging: high energy in a small footprint at a competitive price, with strong

    cycle life. Within lithium-ion, LFP won the stationary market on thermal stability — a higher thermal-

    runaway onset threshold and more forgiving abuse tolerance than nickel-rich chemistries — traded

    against somewhat lower energy density, which matters less when the asset sits on the ground rather

    than in a vehicle.

  • Q5. What does the PCS do, and why is it so critical?

    The PCS is the bidirectional AC/DC translator: rectifier when charging, inverter when discharging. It is a

    single point of consequence — if the PCS fails, the plant can neither charge nor discharge. It also defines

    the plant's grid personality: reactive capability, ride-through behavior, harmonic performance, overload

    headroom, and grid-forming capability all live in the PCS.

  • Q6. What are the four functions of a BMS?

    Monitoring (continuous cell/module temperature, voltage, and current measurement), protection

    (isolating a module when limits are violated, before escalation), performance optimization (SOC/state-

    of-health estimation and cell balancing so dispatch decisions are accurate), and communication

    (constant data exchange with the PCS and EMS). It is an embedded, single-purpose system — the

    watchdog of the battery.

  • Q7. What temperature range do lithium-ion batteries want, and what happens outside it?

    Roughly 20–40 °C for best performance. Colder, and available capacity and performance drop. Hotter,

    and degradation accelerates; at the extreme, electrolyte heating can initiate thermal runaway — a self-

    sustaining exothermic failure. That is why active thermal management is mandatory, not optional.

  • Q8. Liquid cooling or HVAC — which is better?

    It depends on energy density and application. Forced-air HVAC remains viable for lower-density layouts.

    Liquid cooling — pumped coolant through module-level cold plates — has become the default for

    compact, high-density cabinets because it removes heat at the source and holds tighter cell-to-cell

    temperature uniformity, which slows uneven aging. Uniformity is as important as the absolute setpoint.

  • Q9. How is fire risk actually managed in a BESS?

    Through defense in depth, because a developed lithium-ion fire is extremely difficult to extinguish.

    Layers include: stable chemistry selection (LFP), BMS protective isolation, thermal management, early

    detection (smoke, temperature, humidity, and especially off-gas sensors, which detect venting before

    runaway fully develops), suppression scaled to the enclosure (module-level aerosol in cabinets; clean-

    agent, water-based, or deflagration-vented schemes in large containers), physical separation, and

    emergency response planning — the framework of NFPA 855, validated by UL 9540A testing.

  • Q10. What does the EMS actually decide?

    When to charge, when to discharge, and in service of which application — arbitrage, peak shaving,

    frequency response, smoothing, or a stacked combination. It reads state of charge from the BMS and

    commands the PCS accordingly. Two identical hardware plants with different EMS strategies deliver very

    different revenue; the EMS is, in a real sense, the profitability layer of the asset.

  • Q11. How does modular scaling work?

    Capacity grows by paralleling additional cabinets or containers rather than redesigning the plant — one

    more enclosure, double the energy at that node. The same modularity applies inside: a failed module is

    isolated and swapped without disturbing the rack. But scaling headroom must be engineered up front:

    space, DC architecture, transformer and interconnection capacity all have to anticipate it.

  • Q12. What is augmentation and why plan for it at day one?

    Batteries fade; a plant sized exactly to its requirement at commissioning falls short within a few years.

    Augmentation is the planned addition of modules or cabinets over the asset's life to restore capacity.

    Doing it economically requires reserved space, compatible DC architecture, and interconnection

    headroom — decisions that can only be made cheaply at the design stage.

  • Q13. What studies does a BESS interconnection require?

    Typically load flow, short circuit, and protection coordination as a baseline; harmonic analysis against

    IEEE 519; and, increasingly, EMT-level dynamic studies as grid codes for inverter-based resources tighten

    (IEEE 2800 at transmission, IEEE 1547 at distribution). Grid-forming requirements add validation layers

    — benchmarked EMT models, hardware-in-the-loop testing, and staged site tests.

  • Q14. Is a BESS just for storing solar energy overnight?

    No. Energy shifting is one application among many: peak shaving, arbitrage, frequency regulation and

    fast frequency response, renewable output smoothing, reactive power and voltage support,

    transmission and distribution investment deferral, resource adequacy capacity, and black start. The

    most valuable plants stack several services on one asset — which is precisely why EMS strategy and PCS

    capability matter so much.

  • Q15. What most often goes wrong on BESS projects?

    Rarely the battery itself. The recurring failure points are system-level: sizing that ignored degradation

    and auxiliary loads; PCS capability mismatched to grid-code requirements; SOC accuracy problems under

    real service duty; thermal non-uniformity driving early capacity fade; fire-code and AHJ requirements

    addressed too late; and interconnection studies started after equipment was purchased. All are

    preventable with independent engineering early in the project.


Disclaimer

This publication is provided by Keentel Engineering LLC for general informational purposes only and does not constitute engineering, legal, financial, or investment advice for any specific project. Descriptions of equipment, ratings, and performance characteristics are illustrative and vary by product and application. Case studies are representative and anonymized; identifying details have been removed or generalized. Keentel Engineering LLC is not affiliated with, endorsed by, or acting on behalf of any equipment manufacturer, system operator, standards organization, or other entity referenced directly or indirectly herein.


Readers should obtain project-specific engineering analysis before making design, procurement, or investment decisions. ©

2026 Keentel Engineering LLC. All rights reserved.




A smiling man with glasses and a beard wearing a blue blazer stands in front of server racks in a data center.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Four workers in safety vests and helmets stand with arms crossed near wind turbines.

Let's Discuss Your Project

Let's book a call to discuss your electrical engineering project that we can help you with.

Man in a blazer and open shirt, looking at the camera, against a blurred background.

About the Author:

Sandip "Sonny" R. Patel, P.E.

IEEE Senior Member · Founder & CEO, Keentel Engineering

In 1995, Sonny Patel earned his Electrical Engineering degree from the University of Illinois. But degrees don't build legacies — action does.

For three decades, he has worked the power industry from every side of the table: 16 years as a utility engineer at Exelon/Commonwealth Edison; generation leadership across hydroelectric, industrial steam turbine, and a 9 GW renewable fleet; NERC Regional Entity Senior Compliance Engineer and Audit Team Lead, auditing some of the nation's largest utilities; and testing and commissioning lead on equipment up to 765 kV — the very top of the North American grid.

Utility. Generator. Regulator. Consultant. Few engineers have seen all four seats. Fewer still have sat in them.

His experience spans nuclear, hydro, conventional generation, renewables, oil and gas, mining — and today's data centers, where he is authoring a three-book series on data center design. He is a Licensed Professional Engineer in six states and a Licensed Electrical Contractor in Florida (Unlimited EC) — he doesn't just design the work; he's qualified to stand behind its execution.

Today, as Founder and CEO of Keentel Engineering, Sonny leads a nationwide team of engineers delivering substation design, power system studies, NERC compliance, and commissioning — done right, coast to coast.Three decades. Every side of the table. One standard: accountable engineering.

Leave a Comment

Related Posts

Data center capacity planning diagram showing buildable parcels, grid interconnection and EHV substa
By SANDIP R PATEL • October 13, 2026
Plan data center capacity with land screening, MW-per-acre estimates, grid power availability and interconnection feasibility studies from Keentel Engineering.
SLG vs three-phase fault current comparison showing short-circuit current, grounding impedance, and
By SANDIP R PATEL • October 11, 2026
Learn which fault produces the highest current at a bus, why SLG faults can exceed three-phase faults, and how symmetrical components determine fault duty.
Zero-sequence current in dq0 transformation showing three-phase current imbalance, Park frame analys
By SANDIP R PATEL • October 11, 2026
Learn why zero-sequence current pulsates in the dq0 frame, how Park's transformation works, and how inverter controls handle unbalance and ground faults.
Grid inertia and RoCoF comparison showing frequency response, inertial power, and grid stability aft
By SANDIP R PATEL • October 11, 2026
Explore grid inertia, RoCoF and frequency response, with swing equation calculations, frequency nadir analysis and US power system simulation examples.
Transient stability analysis showing swing equation, equal-area criterion, critical clearing angle,
By SANDIP R PATEL • October 11, 2026
Learn transient stability analysis, swing equation, equal-area criterion and critical clearing time with a 345 kV worked example and NERC TPL-001 guidance.
Inverter control stability comparison showing PLL effects, weak-grid voltage oscillations, and EMT s
By SANDIP R PATEL • October 11, 2026
Learn why inverter controls become unstable in weak grids, how PLL bandwidth and SCR affect stability, and how PSCAD EMT studies identify and mitigate oscillations.
STATCOM voltage stability comparison showing 138 kV fault recovery and reactive power support.
By SANDIP R PATEL • October 11, 2026
Learn how STATCOMs improve voltage stability and prevent FIDVR. Explore reactive power sizing, delayed fault clearing, NERC criteria and 138 kV simulation results.
BESS DC sizing and C-rate comparison showing battery capacity, discharge rates, and energy storage s
By SANDIP R PATEL • October 10, 2026
Learn BESS DC sizing with power, energy, current and C-rate calculations, battery losses, degradation and a 100 MW/400 MWh utility-scale example.
BESS ROI and value stacking comparison showing battery energy storage revenue streams, peak shaving,
By SANDIP R PATEL • October 10, 2026
Learn how BESS ROI is calculated using peak shaving, energy arbitrage, power quality and battery storage economics, with a practical 5 MW/10 MWh example.
